east Project

Home > Projects > EAST

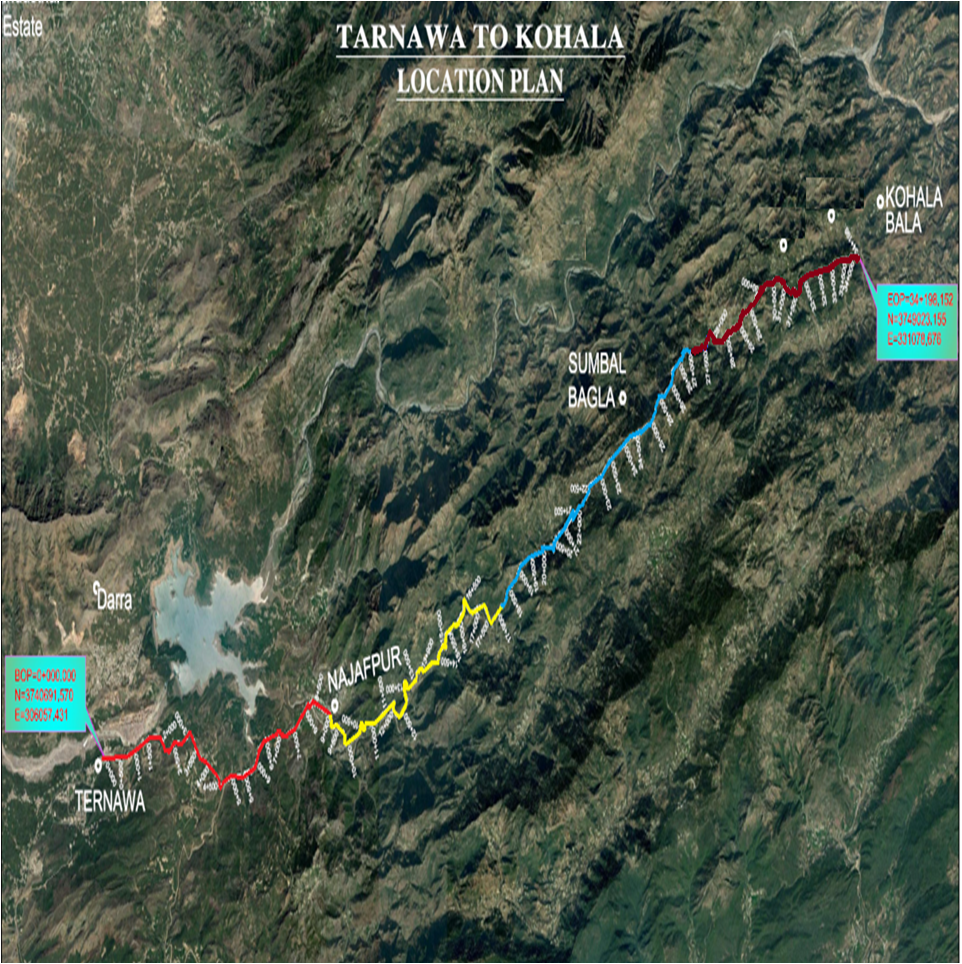

Widening & Improvement of Tarnawa To Kohala Bala Road ( 34 km ) District Haripur (ADP No.1545/170629 2022-23 )

PROJECT BRIEF
Original PC-I Cost :  Rs. 2232.195 (M), 11-02-2019
Revised PC-I Cost :  Rs. 2221.880 (M), 01-06-2022
CFY Allocation :  Rs. 80.00 (M)
CFY Releases :  Rs. 40.00 (M)
Up to Date Expenditure :  Rs. 1086.662 (M)
Up to Date Financial Progress :  48.90 %

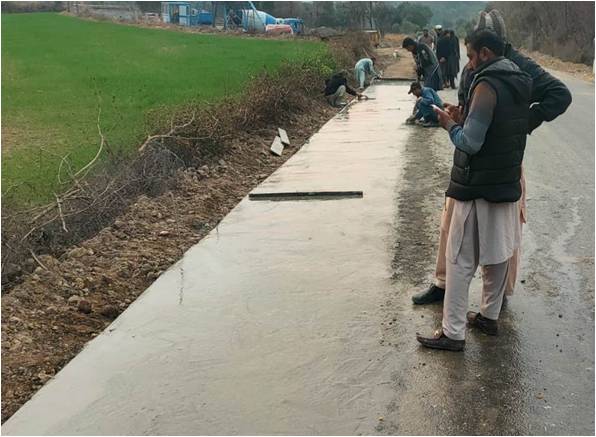

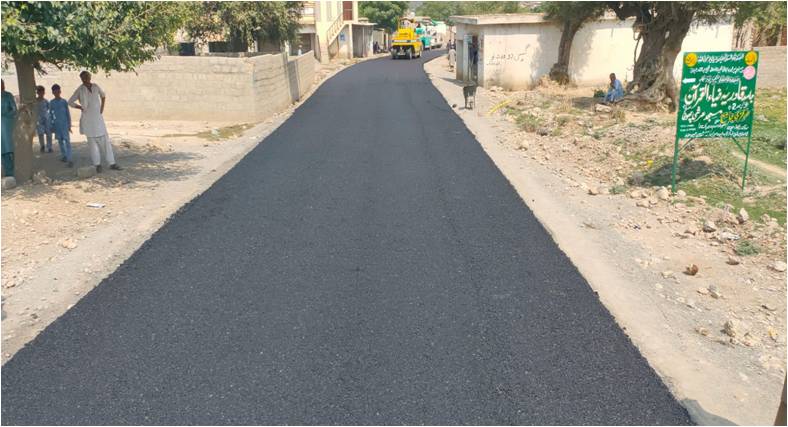

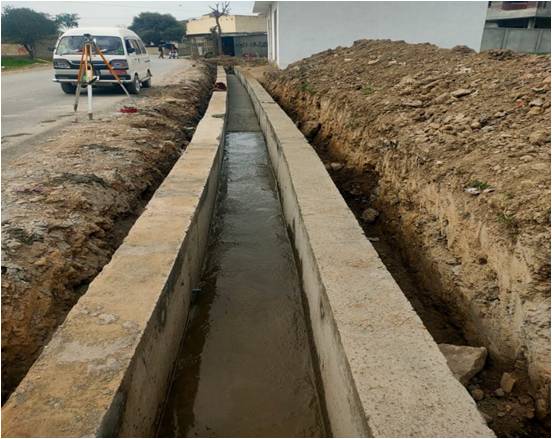

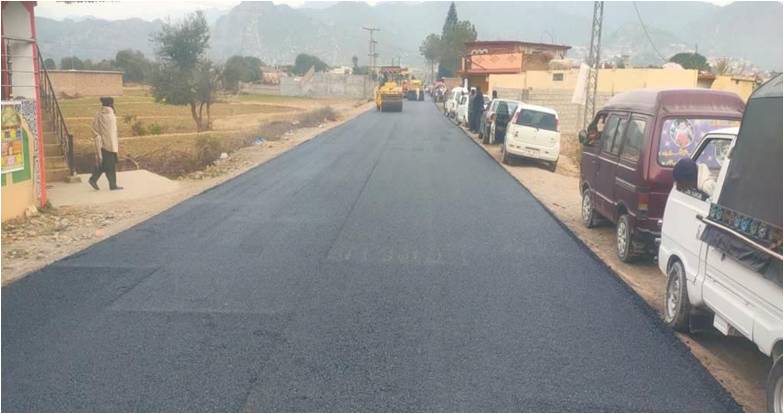

Up to date Physical Progress :  50.22 %
Date of Commencement :  May 2019
Date of Completion as per PC-I :  May 2022
Date of Completion (EOT applied) :  May 2024
Design Consultant :  M/S AAA, Karachi, M/S PCE, Peshawar (JV)
Supervisory Consultant :  M/S ACE Lahore, MS PAVRON, Islamabad (JV)
Contractors:
 Package-I: From 0+000 to 9+000, M/S Z.S Construction (PVT) Ltd
 Package-II : From 9+000 to 18+000, M/S Badi-uz-Zaman khan & Co. (PVT) Ltd.
 Package-III : From 18+000 to 27+000, M/S Haji Raees Khan & Sons Construction Co.
 Package-IV : From 27+000 to 33+860, M/S Haji Raees Khan & Sons Construction Co.
