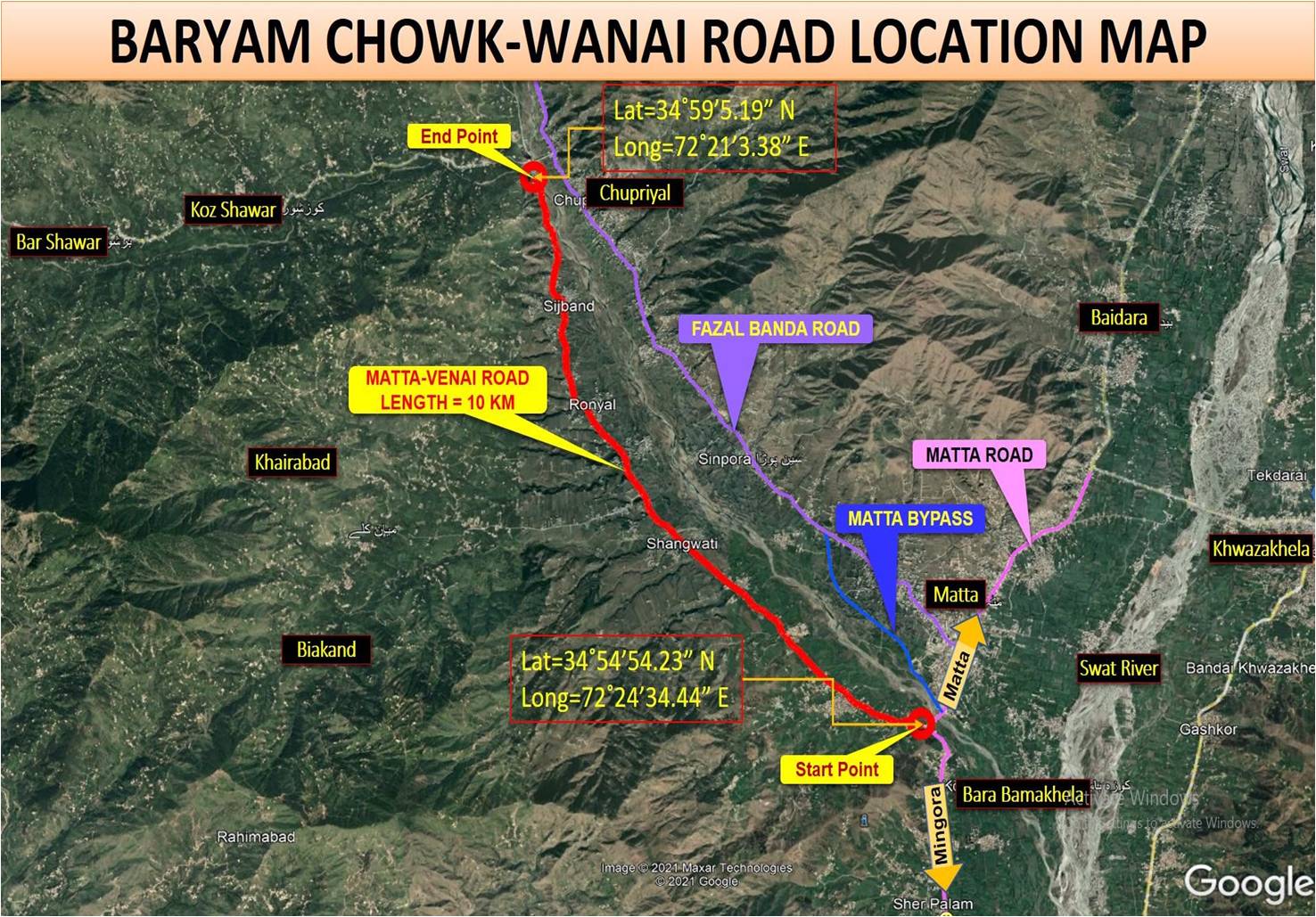

Widening & Rehabilitation of Road from Baryam Chowk to Wanai Matta District Swat (10.3 km).
SALIENT FEATURES:
PC-1 Cost: Rs: 670.380 (Millions)
Bid Cost: Rs: 513.675 (Millions)
PDWP /18-10-2023
Date of Work Order: 29/06/2022
Date of Commencement: 29-06-2022
Date of Completion: 29-12-2026
Time Period: 18 Months
Length of Project: 10.300 Km
Allocation During CFY: Rs. 50.00 (M)
Release During CFY: Rs. 16.500 (M)

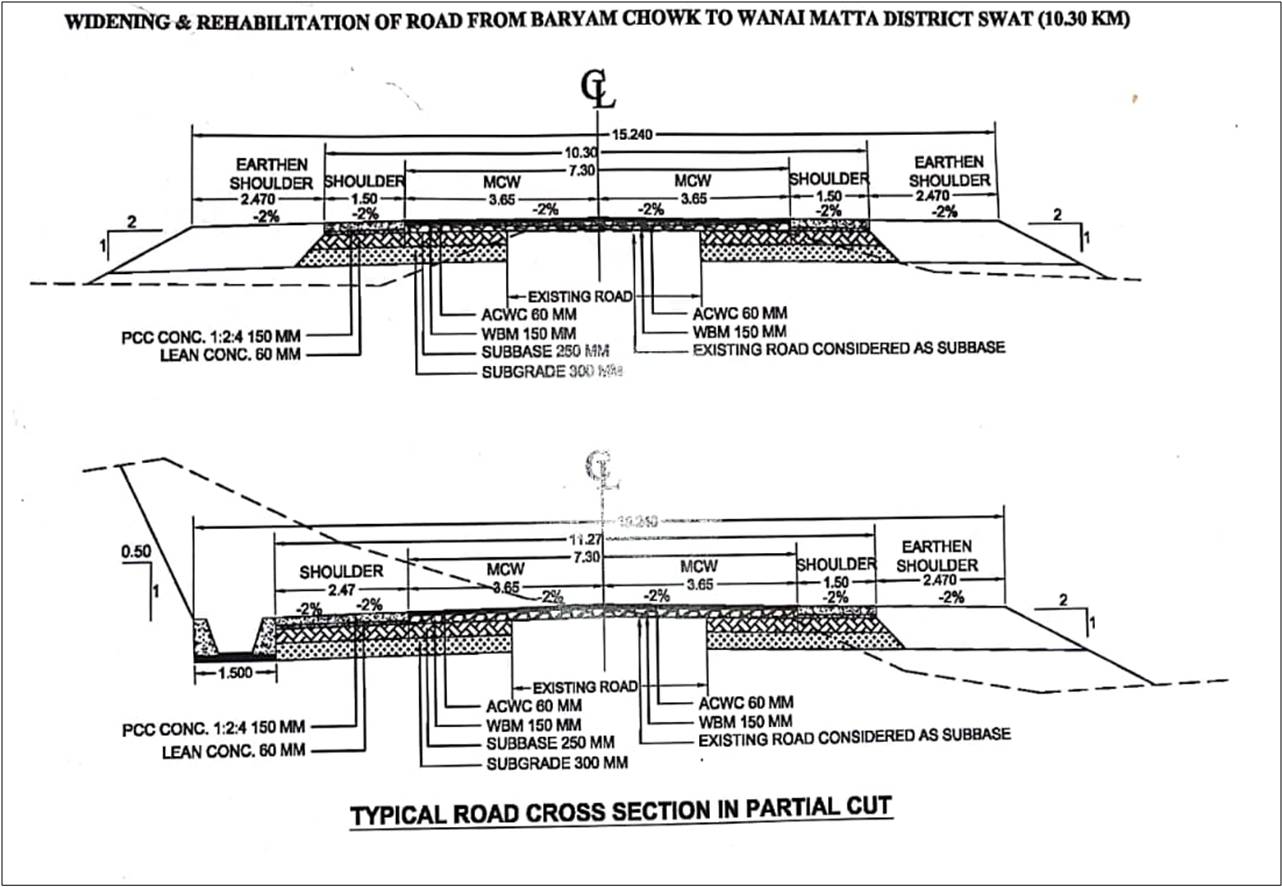

Formation Width: 10.30 m
Culverts: 51 Nos.
Right of Way : 15.24 m (50 Ft.)
Consultants : M/s NESPAK (Pvt.) Ltd.
Contractor : M/s Aman Ullah Khan & Co.

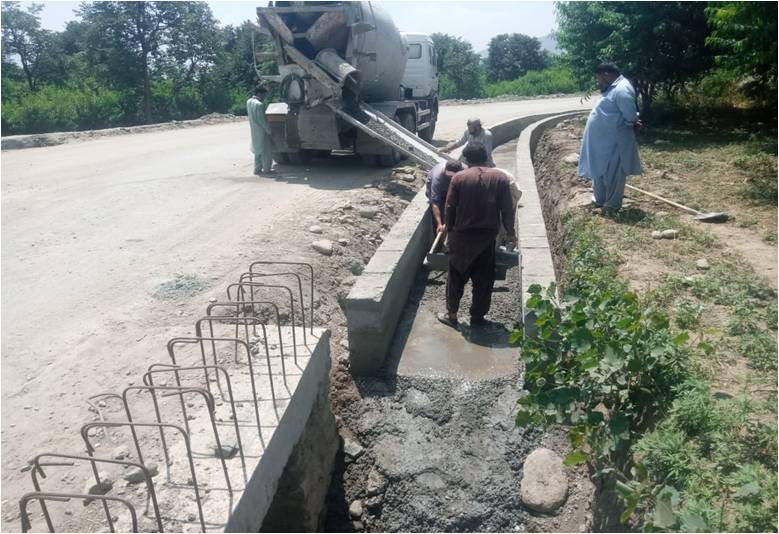

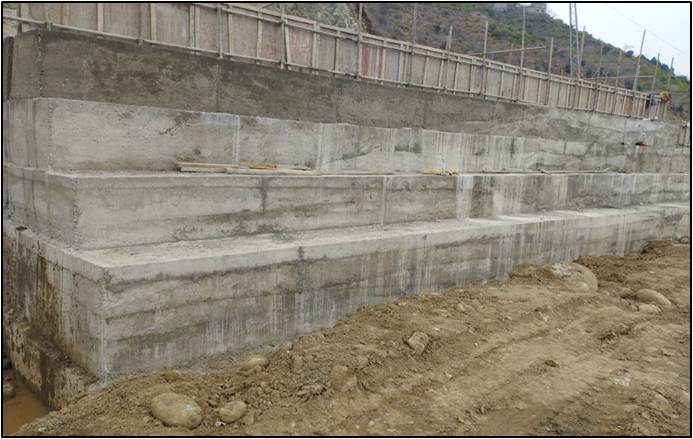

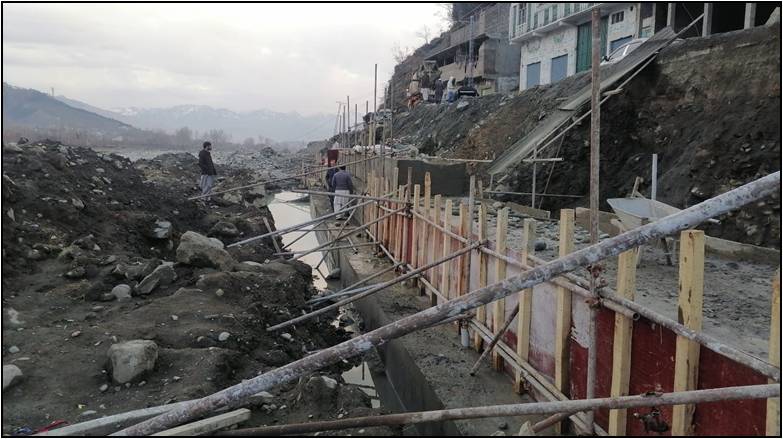

PROJECT PROGRESS:
Financial Progress 51.53 %
Physical Progress 70.32%
